PROGRESS REPORT FOR MONTH OF DECEMBER 2023

Dear Valued Customer, We are excited to share with you the latest update on the construction progress for your new home at MAYAS GENEVA Since our last update, mechanical, electrical and plumbing engineering (MEP) work and external finishes are nearing completion.

Project Details:
G+P+5+R Residential & Commercial Building on Plot No. 391 JVC14AMRA002 Jumeirah Village Circle, Dubai UAE
The Date of Report:
19th January 2024
Overview:
  • Section 1: Internal Finishes (First to Fifth Floor)
  • Section 2: Structural Work

SECTION 1: Internal Finishes (First to Fifth Floor)

  • Installation a coat of primer, two coats of stucco, and two coats of emulsion paints for walls and ceilings for kitchens, laundries, living rooms, bedrooms, and main corridorsG floor parking area concreting 95%
  • Installation timber doors' shutters and frames 85%
  • Installation aluminium's glasses and frame 90%
  • Installation kitchens cabinets 80%
  • Installation kitchens cabinets 80%

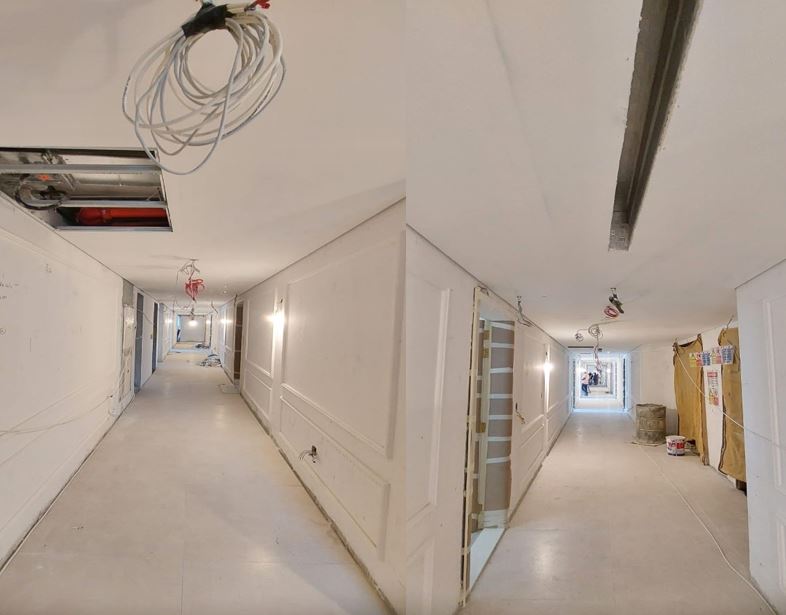

  • Installation gypsum board ceiling for the main corridor 30%
  • Installation gypsum board ceiling for living rooms, bedrooms, and kitchens (First to Fifth Floor) 100%

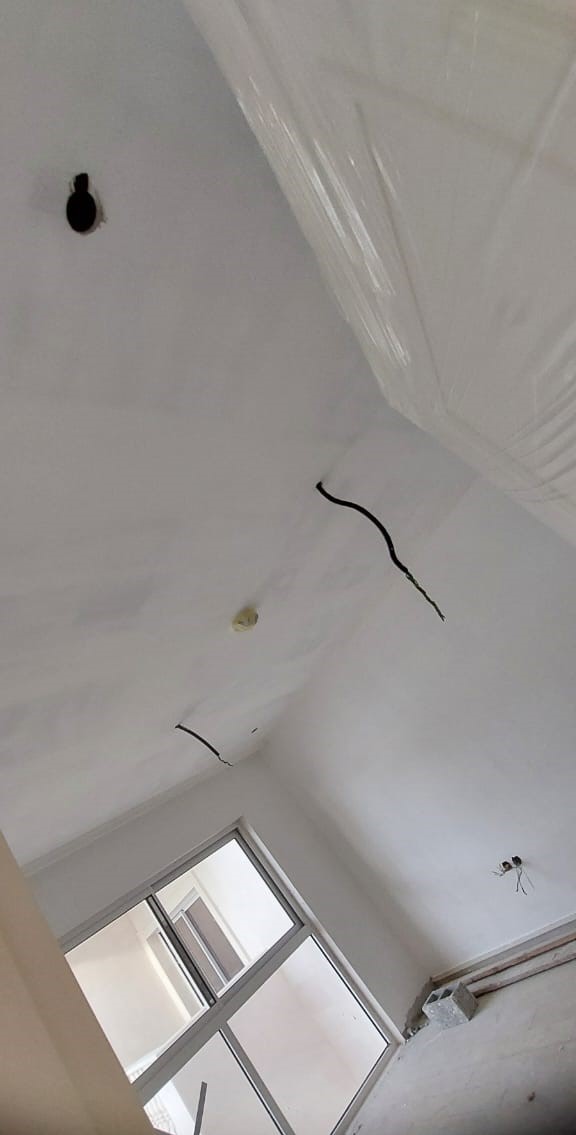

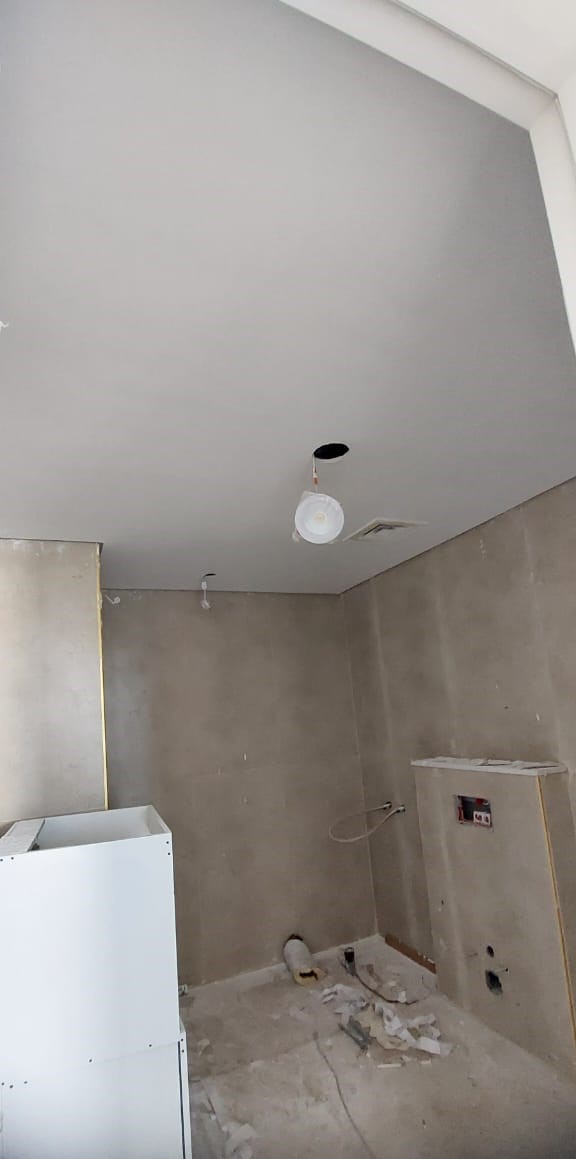

  • Installation gypsum board ceiling for bathrooms and laundries 60%

SECTION 2: Structural Work

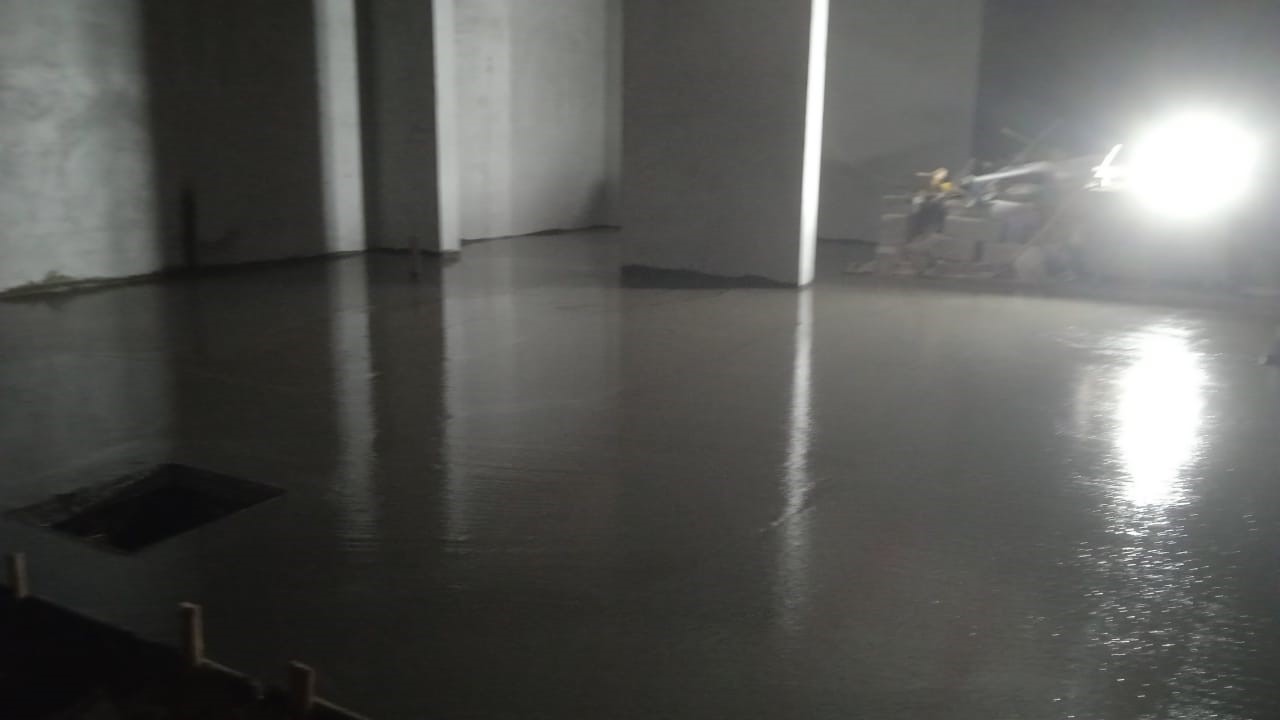

  • Ground Floor: Concreting the blinding slab 100%
  • Ground Floor: Installation shutter and steel for generator room 100%

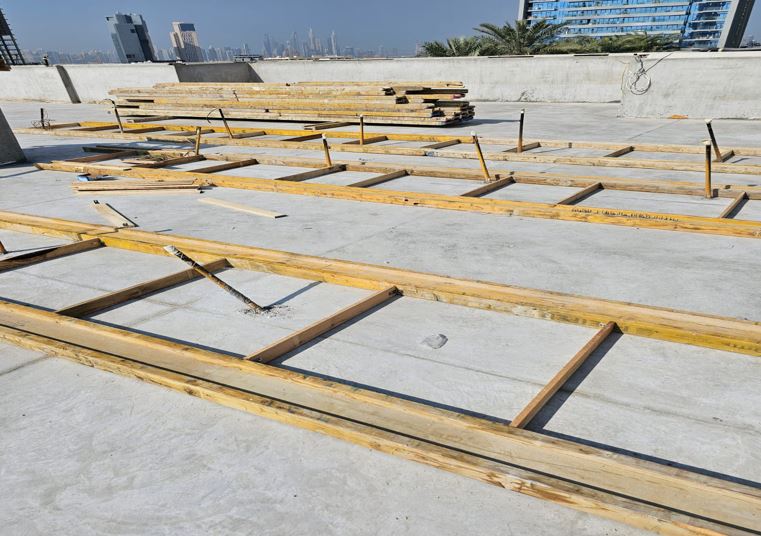

  • Roof Floor: Concreting the AC foundation (136 PCS) 100%
